Production
Planning and Scheduling Jobs
Objective
Use this exercise to learn how to plan, schedule, and release a job. The job record you will create in this exercise will be a job to fill the order you created in the Entering a Sales Order exercise. For this exercise, you will be using Vantage's new Order-to-Job linking feature.
To learn how to enter a job manually, see the online help "Entering a New Job."
1)     From the Production Management menu, select Job Management, then General Operations, and then Job Entry.

2)     The Job Entry window appears:
3)     Create a job to fill the order from the Entering a Sales Order exercise: go to Suggestions. The Manufacturing Suggestions browser appears, with a list of new and changed order entries. Find one of the releases of the DCD-100-SP that you are to manufacture for Manny at Dalton. Highlight that release, and then click the Select button.

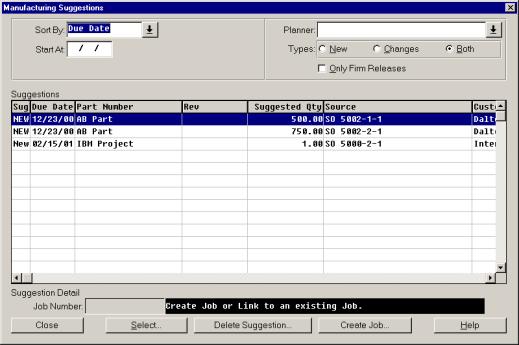

4)     The Manufacturing Links browser appears with all of the manufacturing information related to the selected part. Highlight the appropriate DCD-100-SP release in the Demand list, and click Create Job.
5)     A window prompts you to enter the job number for the new job. To assign a job number, you can define your own job number, let the system assign the job number as the next number, or let the system assign the order release number as the job number. You can also append the next sequential job number to your own identifier.
Assign the number in this way: enter your initials followed by a dash in the New Job field (for example, "RPF-"), then click Next Job The system adds the job number to your initials. For example, if the most recently entered job before this is 1233, this job number becomes "RPF-1234." When you verify that the job number is accurate, click OK. You are returned to the Manufacturing Links window. Click Close.
6)     When you are returned to the Job Entry window, enter the job number for the job. If you do not remember, use the Search button.
7)     Establish the production details for the job, including the assemblies and subassemblies that compose the completed part, the materials that are used to make each assembly, and the operations that must be performed on each assembly. For this particular job, you already defined the production details when you generated the quote, so you can retrieve the details from this quote record. Select the Get Details menu option.
8)     The quantity of the material record needs to be changed (the quote was not quite correct). To make the change, highlight the material record in the Materials browser and double click. This will take you to Main Plant Job Entry. Highlight the material in the Material browser: material sequence 10, part number SS-125. Then, from the Material menu, select Update.

9)     The Material Maintenance window shows information about the material record that is being updated and retrieved from the associated quote. For this exercise, change the Qty/Parent, which is the quantity of the material required to produce one of the assemblies with which it is associated. For this exercise, increase the Qty/Parent by .02. The Required Qty is increased automatically. Once you make this change, click OK to return to the Job Entry window.
10) Give some special instructions to your shear operator: Highlight the Shear operation in the Operations browser (most likely Operation Sequence 10). Then from the Operations menu, select Update. The Job Operation Maintenance window appears.

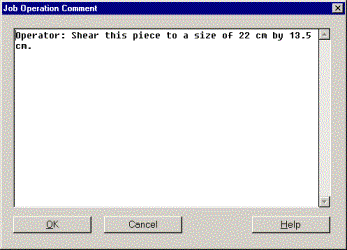

11) Click the Comments button at the bottom of the screen. The Job Operation Comment window appears. In this window enter your special instructions: Operator: Shear this piece to a size of 22 cm by 13.5 cm. To return to the operation maintenance window, click OK. To return to the initial job entry window, click OK again.
12) Associate people with your job, so that any alarms and warnings generated by this job will be sent to the appropriate personnel: Go to Job, select Update. In the Job Header Maintenance window, from the Prod. Team combo box, select Team A, and from the Planner combo box, select <Your Name>. Click OK.
13) The job is now engineered: You defined exactly what materials need to be used and what operations need to be performed in order to create each assembly for this part. To indicate that you completed the planning for the job, from the Job menu, select Update. The job header maintenance window appears. In this window, mark the toggle box labeled Engineered. Then to return to the initial Job Entry window, select OK.
14) Once the job has been marked as engineered, you can schedule it. To schedule the job, from the Schedule menu option, select the Job Scheduling. This menu option is disabled until you mark the job as engineered. The Schedule Job window appears.
15) Schedule this job backwards, so that it is completed by a fixed date: click the Backward scheduling method. By default, the Production Due Date is the required due date for the job. Leave it as this default setting. Vantage will schedule the job to be finished as close to this date as possible.
16) Use the Schedule as What-If toggle box to temporarily schedule a job to see how it affects the rest of the schedule. You can accept or reject the proposed schedule later. For now, do not schedule the job as what-if. Leave the box unmarked.
17) Click OK and the job will be scheduled. Once the job is scheduled, you are returned to the initial Job Entry window.
Although Vantage tries to assign an appropriate schedule, at some point you will likely want to review and change this schedule through the Visual Scheduling Module. For more information, consult Online Help.
18) Until a job is released to the floor, nobody can work on it. It does not appear on dispatch lists or work queues. In practice, jobs are not marked as released to the shop floor until the schedule has been manipulated and necessary raw materials have been purchased, but for now, presume that you are ready to work on the job. Release the record to your shop floor: from the Job menu, select Update. In the Job Header Maintenance window, check the Released box. To return to the Job Entry window, click OK.
19) Examine the Job Entry window, and verify that everything is correct. To exit the program, from the File menu, select Exit.
Using Vantage Visual Scheduling
Objective
This exercise will teach you how to use a job scheduling board and a work center scheduling board.  You will use these scheduling boards to adjust the schedule of the job you scheduled for Dalton in the Planning, Scheduling, and Releasing Jobs exercise.

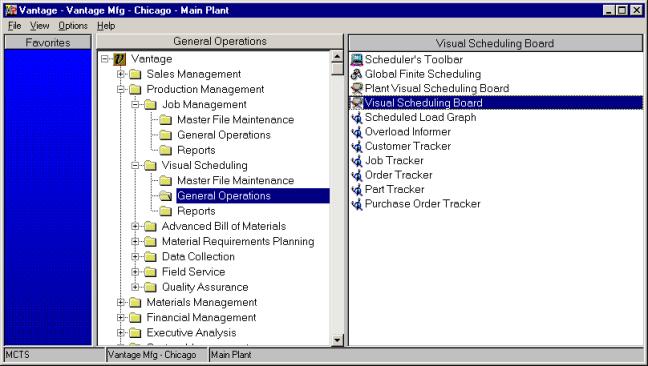

1)     From the Production Management menu, select Visual Scheduling, then General Operations, and then Visual Scheduling Board

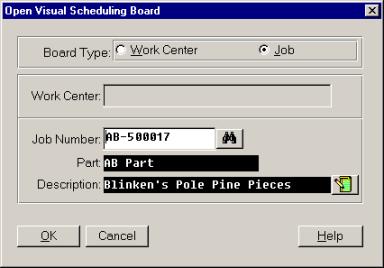

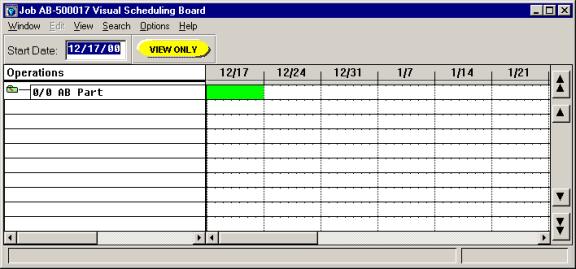

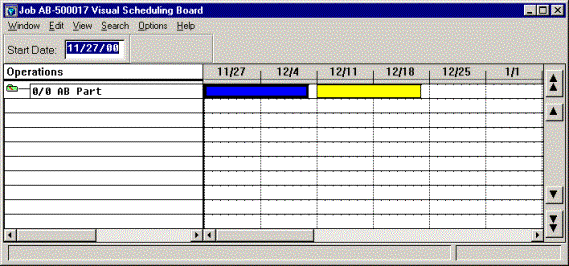

2)     The Open Visual Scheduling Board window appears:
3)     You can choose to view one of two types of Visual Scheduling boards: a work center scheduling board, which shows all the job operations scheduled at a particular work center, or a job scheduling board, which depicts the schedule of a specific job.  For this exercise, you want to view the schedule for the job you created in the Planning, Scheduling, and Releasing a Job exercise.  Select Job as the window type.

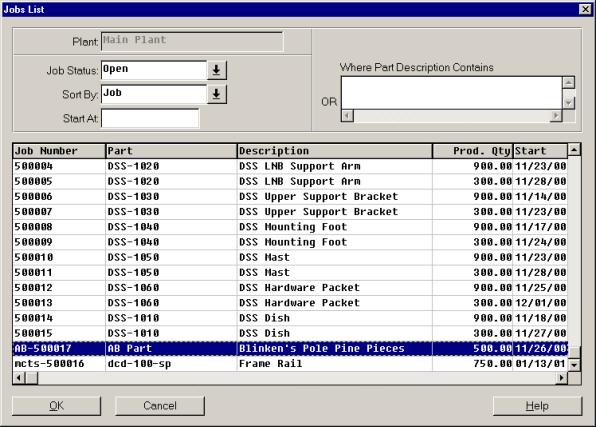

4)     Enter the job number of the job you are performing for Dalton in the Job Number field.  Use the search function to select this job if you need to.  Once you select the job, click OK.  This job's scheduling board will appear.  This type of scheduling board shows the schedule for all assemblies and operation on a particular job.
5)     For this exercise, select the View menu and make sure the Assemblies Only option is not marked.  You want to view the job's individual operations as well as its assemblies.

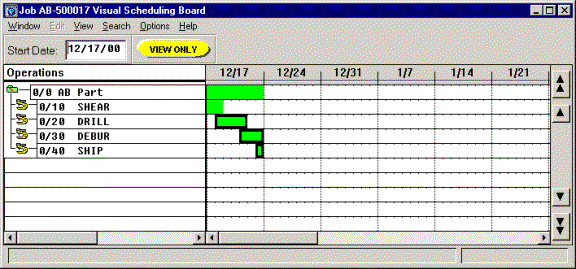

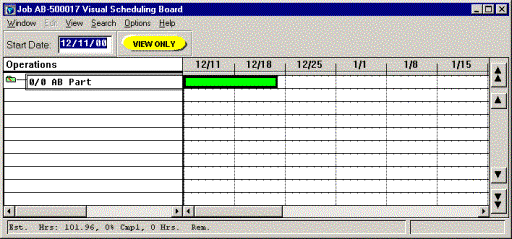

6)     Take a moment to review the scheduling board.  The outline-like list on the left identifies all the assemblies and operations that have been defined for this job.  The rectangular bars in the board represent when the corresponding operations are scheduled.  They are positioned according to the dates at the top of the board.
If the schedule bar for a particular assembly or operation does not appear in the board, highlight that assembly or operation in the list on the left. Go to  View, then select Start at Operation, or press [ALT]+S on your keyboard.  The scheduling board will be repositioned to show that assembly or operation's scheduled block.  You can also use the Start Date field and the scroll bars to reposition the display.
7)     Before you can move an operation or an assembly, you need to change the schedule from View-Only mode to What-If mode. Go to Options, delect What-If Mode.  Once the board is in what-if mode, you can change the schedule.  The changes you propose, however, will merely be "what-if" changes, not definite changes.  What-if scheduling allows you to see how changes affect the rest of your schedule.  You will choose to accept or reject what-if changes later.
8)     For this exercise, you want to move the schedule for the entire job to a point two weeks earlier.  First, change the Start At date to a point at two weeks before the scheduled start date.  Then click the top row in the scheduling board, the row that represents assembly 0, the final part.  Notice that this row spans the operations for the entire job.  Also notice that basic information about the highlighted row is displayed in the status bar at the bottom of the window.
9)     To change an assembly or operation's scheduled time, drag and drop the schedule bar to the new place by positioning your mouse pointer over the bar, holding down your left mouse button, and dragging the item to the new position.  For this exercise, drag the schedule bar to a point two weeks earlier.  In order to move the schedule, you may need to first reposition the board so that open blocks of time are displayed to the left of the board.  Use the scroll bars at the bottom of the screen to reposition the board in this manner.

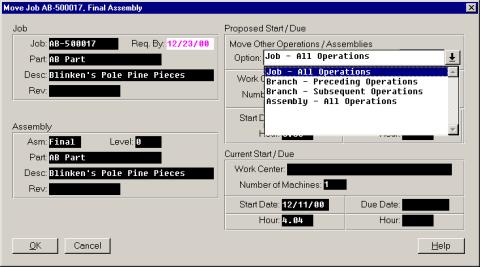

10) When you drag and drop the schedule bar for an assembly or operation, a new window will appear.  This will show the initial schedule for this operation as well as the schedule you are proposing.  Note the Move Other Operations/Assemblies field. This is where you define how the other operations for this job should be affected by the changes you are proposing to this particular operation or assembly.  For this exercise, select the Job - All Operations option.  You want to change the schedule for the entire job.  Then click OK.
11) The job's operations will be rescheduled and the scheduling board will be redisplayed.  Notice that now two bars appear for each operation on the job, one representing the original schedule and the other representing the proposed change to the schedule.  You can choose to remove or display the bars representing the original schedule by selecting the Original Location option on the View menu.  Notice that the colors used to display the two bars are different.  You can customize the colors used by selecting Change Colors from the Options menu.

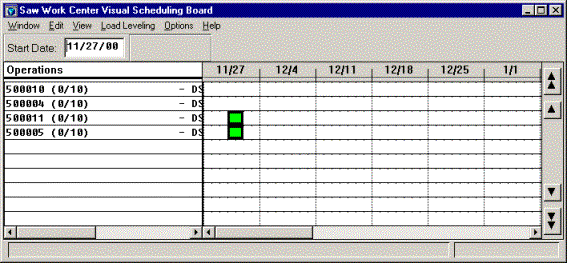

12) You have now proposed changes to this job's schedule.  But you also want to know how this change might affect other operations which are scheduled to be performed at the work centers where this job's operations are performed.  Go to Window, select Open.  The Open Visual Scheduling Board dialog box will appear again.  This time, select Work Center as the window type. Use the Work Center field's drop-down list to select the work center whose schedule you want to review.   For this exercise, select Shear 4ft - Amada, the work center you are planning to use for the shear operation on your job for Dalton.  Then click OK.

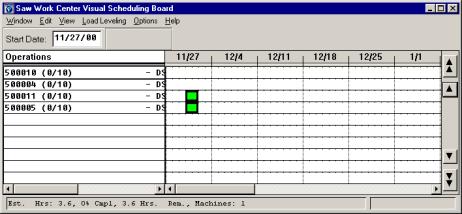

The scheduling board for that work center will appear. This new board is not the same as the first board you opened--it is a work center scheduling board, and shows all the operations scheduled to be performed at a particular work center.
13) The list on the left shows all the job operations currently scheduled for that work center.  See it?  It should look like this: Job number (assembly number/operation number) - part number - operation description.  For example, JCS-12345 (0/10) - DCD-100-SP - SHEAR.  If this information isn't entirely visible, use the horizontal scroll bar underneath the operations list. Is there a rectangular bar corresponding to this job visible in the scheduling board?  If not, the board is not currently positioned to display the operation.
Click the operation in the list.  The board will be repositioned to show the rectangular bar representing this operation.  The status bar at the bottom of the window shows basic information about the operation in the highlighted row.
14) The row for this operation should in fact contain two bars: one representing the original schedule and one representing the what-if schedule you proposed in the job schedule board.  You can move a schedule bar in either type of board and the changes will be reflected in the other board.
15) The changes you have made are only proposed changes, known in Vantage as What-If changes.  You make these changes to see how the rest of your shop and job might be affected.  Once you see the effect of these changes, you can decide whether or not to accept them.  You accept changes by selecting Accept All Changes or Accept Current Job Changes from the Edit menu.  For this exercise, you want to accept the proposed changes to the schedule.  Go to Edit, select Accept Changes.  The schedule will be redisplayed to show the what-if changes as the actual schedule.
15) Close the scheduling boards by selecting Exit from each board's Window menu.
Note: If this situation had actually occurred, you probably would also want to change the required due date for the order through the Order Management module and the required ship date for the job through the Job Management module.

Entering Labor Information
Objective
This exercise will teach you how to enter labor records through the Job Management module's Labor Entry program.  Use this program if you do not want to collect labor information directly from the floor through the Data Collection module.  You can also use Labor Entry to enter records that adjust or augment those records entered through Data Collection.  For this exercise you will enter a labor record that accounts for the work performed by an employee who did not use Data Collection to clock in and out.

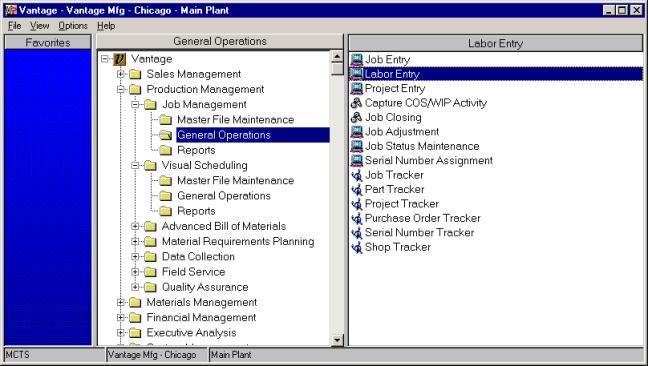

1)     From the Production menu, select Job Management, then General Operations, and then Labor Entry.

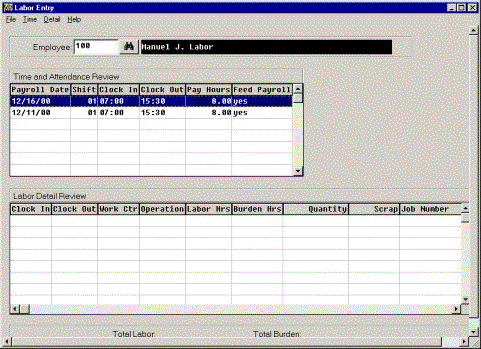

2)     The initial Labor Entry window will appear.

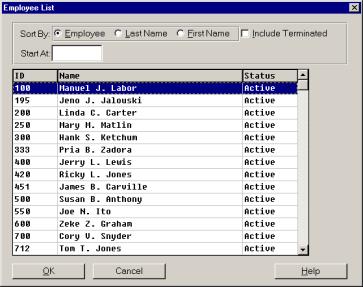

3)     In the Employee ID field, enter the employee ID of the employee whose labor information you want to enter or maintain.  For this exercise you will be entering the timecard of an employee named Manuel J. Labor. Enter 100, Manuel J. Labor's employee ID, in the Employee ID field.  If you needed to find an employee, you could use the search function.
Note that once you enter the employee, the rest of the screen is filled with information about the labor that has been performed by this employee.
4)     For this exercise you want to enter an entirely new labor record for Manuel.  Go to Time, select Add Time.  The Time and Attendance Maintenance window will appear.

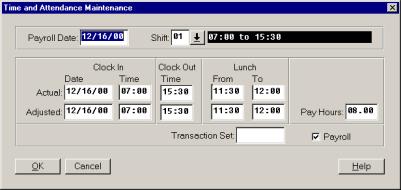

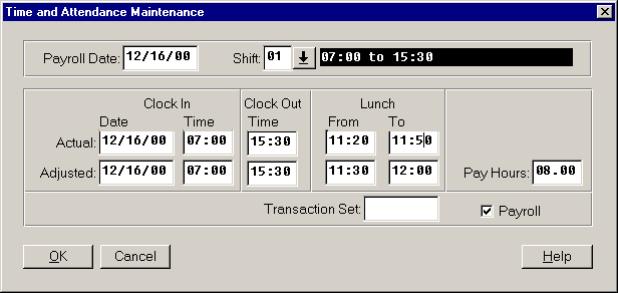

5)     In the Payroll Date field enter the date of the timecard record you are entering.   For this exercise, say that the work you are entering occurred yesterday.  Enter yesterday's date.
6)     In the Shift field enter the labor shift during which the record occurred.  For this exercise, select shift 01, which is predefined in the Vantage Training database as a shift that runs from 07:00 to 15:30.  Note, however, that if you changed this shift's default settings in the Maintaining Shift Records exercise, the shift's start and end times will be different.
7)     For this exercise, leave the Actual and Adjusted Date, Clock In, and Clock Out times at their default settings.  They should be set according to the start and end times defined for this shift.  Enter a half hour lunchtime by entering an actual and adjusted lunch start time and end time that are thirty minutes apart.  The payroll hours are automatically calculated.
8)     For this exercise do not enter any value in the Transaction Set field.  Make sure the Payroll box is marked.  You want to generate payroll records from this labor.

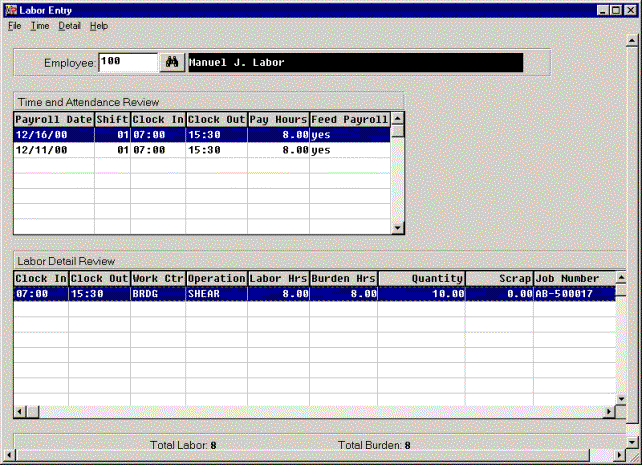

9)     Click OK at the Time and Attendance Maintenance window.  You will return to the initial Labor Entry screen.
10) You now need to enter the labor detail information for this time and attendance record.  Labor detail records define precisely what the employee did during this time.  Make sure the Time and Attendance record you just entered is highlighted in the Time and Attendance Review browser.  Go to Detail, select Add Detail. The Labor Detail Maintenance window will appear:

11) Select Production as the Labor Type.  The labor record you are adding is production on a job.
12) For Production and Setup labor types you need to select the job on which the labor was performed.  Tab to the Job Number field.  Use the search function to select an open job.  If you have set up a job in the Planning, Scheduling, and Releasing a Job lesson, choose that job.  Otherwise, select another open job.
13) Once you have selected a job, select the particular assembly on which the labor was performed and the specific operation that this labor represents.  For this exercise, select the first operation on the first assembly--this will probably be assembly 0, operation 10.
14) In the Labor Quantity field enter the number of pieces that were completed during this labor.  For this exercise say you completed 10 pieces.  Enter that quantity.  For this exercise, do not enter any scrap quantity.
15) The Labor Date is, by default, the date you entered in the time and attendance header record.  For this exercise, do not change this default.
16) The Clock in and Clock out times define when Manuel began and ended working on this particular labor detail.  The beginning and end of the shift should be the defaults in these fields.  For this exercise, say that Manuel spent the entire shift working on this particular job: do not change these default settings.
17) The default labor and burden hours are calculated automatically based on the clock in and clock out times for this labor detail record.  For this exercise leave these at these defaults.  This should be 8.00 hours.
18) Tab to the Expense Code field.  Select any expense code from the drop-down list.  Use the default code if you want.
19) Mark both the Complete and Opr. complete boxes.  This labor detail completes the production for the operation and the operation itself.
20) Leave the Work Center, Department, and Operation at their default settings.  These defaults were defined when you set up the job.
21) Click the Save button.  The detail line window will appear again.  This is because in practice you would often add several detail lines in succession for a single Time and Attendance record.  For this exercise, however, you do not want to enter more than one detail line record.  Click Cancel at this window.  You will return to the initial Time and Attendance window.
22) Notice that the labor detail record now appears in the browser at the bottom of the window.  Confirm that the line seems accurate.
22) Select Exit from the File menu to exit the program.
Completing and Closing Jobs
Objective
Use this exercise to learn how to complete and close a job record. Completed jobs are jobs on which all production has been completed but that have not yet had all costs posted against them. Closed jobs are jobs that have been produced and costed completely. In this exercise, you will mark the job you created in the Planning, Scheduling, and Releasing a Job exercise as both closed and complete. You will then reopen the job so that you can use it throughout the rest of this tutorial.
Note: In actual practice you will not complete or close a job until you have actually produced the part. This exercise, then, may seem to be out of sequence. It appears here because it is performed through the Job Management module.

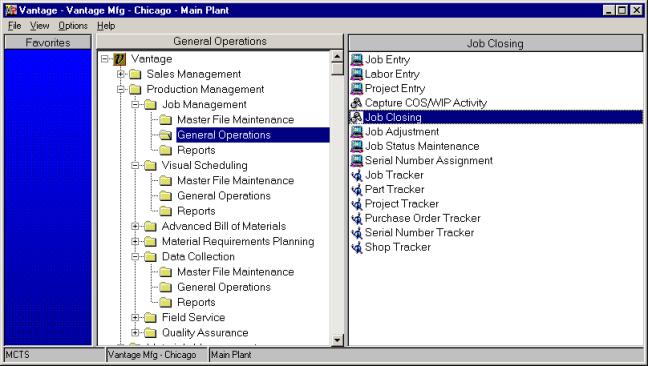

1)     From the Production Management, select Job Management, then General Operations, and then Job Closing.

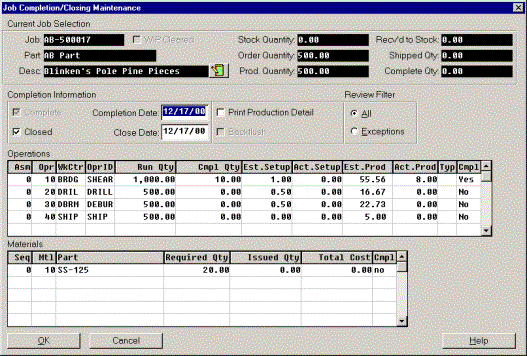

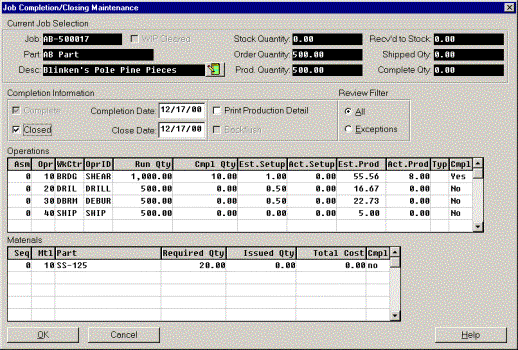

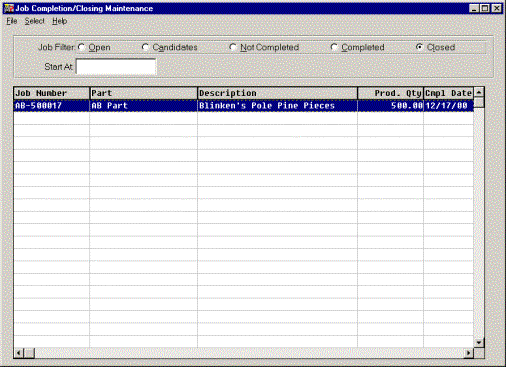

2)     The Jobs Completion/Closing Maintenance browser appears:

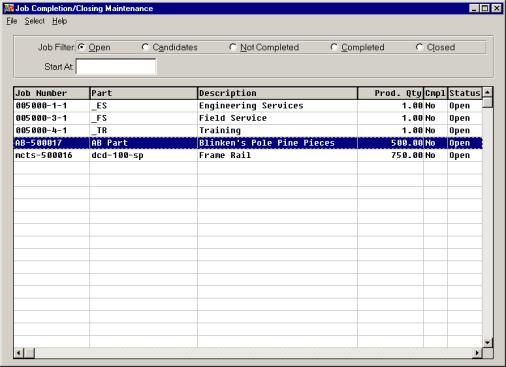

3)     In this browser find the job you created in the Planning, Scheduling, and Releasing a Job exercise. This should be an open job--make sure the Job Filter is set to Open. Use the Start At prompt to help find this job. Highlight this job. Then click the Select menu option. The Job Completion/Closing dialog box appears:
4)     This window displays a variety of information about the job. You should review this information and verify its accuracy before closing or completing a job. For this exercise, the Complete Qty. is probably zero, since you have probably not yet performed any labor that marks this job complete.

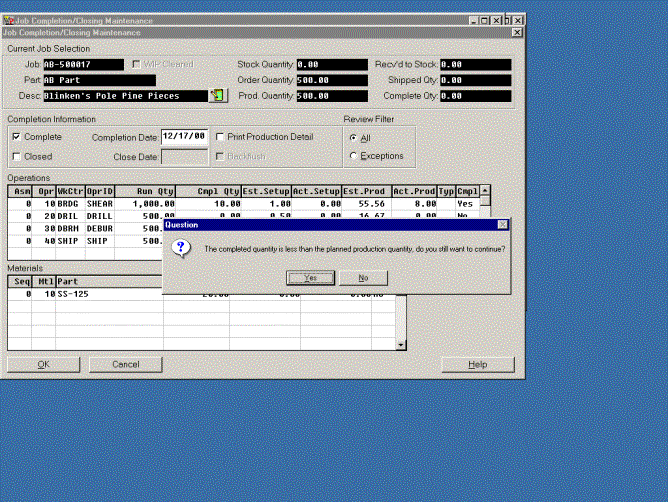

5)     Mark the Complete toggle box. By doing so, you are indicating that production is complete on this job. For this exercise, a message may appear informing you that you are marking the job complete even though the quantity completed is less than the engineered quantity. Click Yes at this message. In the Completion Date field, enter the date on which this job was completed. By default, this is the current date.
6)     Mark the Closed toggle box. By doing so, you are indicating that all costs have been posted to this job.
7)     Once the job is marked as both complete and closed, select OK. You will return to the initial Job Closing/Completion screen.

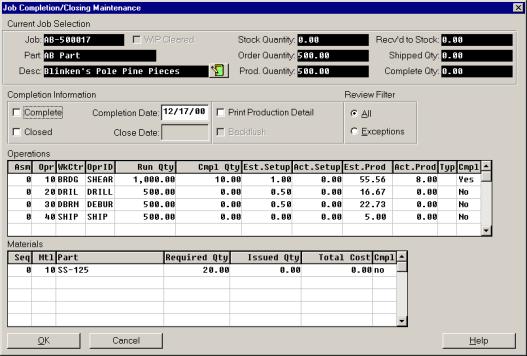

8)     For this exercise, you should reopen the job you just closed and completed, since you will need to use this job throughout the remainder of this tutorial. Select Closed as the filter. Then find the job you just completed and closed in the browser.
9)     Use the Start At to more quickly find this job. Highlight this job and click the Select menu option.
The Job Completion/Closing window appears again. Unmark the Closed toggle box. Then unmark the Complete toggle box. Then click OK to return to the browser of jobs. Select Exit from the File menu to exit the program.
Creating a BOM
Building Bill of Material

From the Vantage main menu, select  Production Management, Advanced Bill of Materials, then Master File Maintenance, and then Part.  The browser of parts will appear.  Note that the browser is in fact two browsers--one of parts and one of all revisions for the currently highlighted part.
Enter new parts in Part Master File for building simplified BOM.  Use your initials to create unique part numbers for the following bill of material.

Open the Part Master File, Select the Add button at the bottom of the Parts List section. The Part Maintenance dialog window will appear
Decide to create Top Assy, (initials) test1
Subassy, (Initials)test 2 is made up of two parts
As you add your parts, use Manufactured for the assemblies and Purchased for the parts.
For the sake of time, we will only fill in the Part field and the Description field.

Part

(Initials)test1

(Initials)test2

(Initials)test2a

(Initials)test2b

Description

(Initials) Top Assy,

(Initials) Subassy

(Initials) Test part 2a

(Initials) Test part 2b

Basics of building a BOM:
BOM are associated at revision level, you need to add a revision level to associate parts.
Start with (Initials)test2, (Initials) Subassy

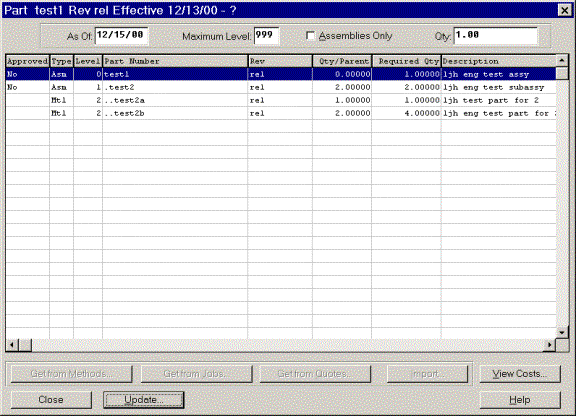

1) Add a revision level to your part, Click on the Add button under the Revisions section.
Add revision information the same as above for each part number.  Rev rel, Description initial release, leave in the default effective date and add rel1000 for ECO number, click on OK.
You will be back at the part file maintenance window.  Click on BOM&
Note:  Before there was a revision, your only button choice was Add  Now that there is a revision on the part the other buttons are available.

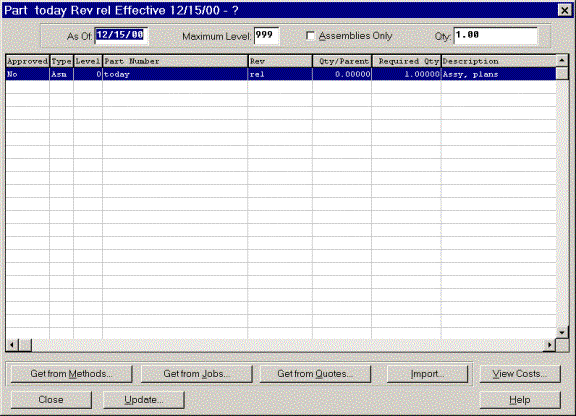

This shows your assy at level 0.
The options are:
          Get from Methods
          Get from Jobs
          Get from Quotes
          Import
We will talk about these options for copying an existing BOM to your new part later, after we create a manual bill.
2) Pick Update on the BOM screen
This opens up window Methods Maintenance  The yellow Not Approved reflects that the revision level is not approved.  This is the way it would be in the stage of writing an Engineering Change Order.  The approval would not be changed until completion of the ECO.
3) On Methods Maintenance screen, Click on the Add button under the Materials section of the window.
This window allows you to search for the part from the part master.  Click on the binoculars and search for your part, test2a

4) Add your part.  You must show the quantity needed for the parent assembly, in this example, I picked 4 for Qty/Parent and checked a fixed quantity.

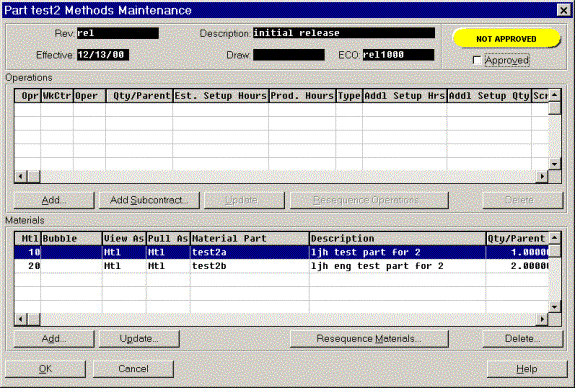

Click OK and you return to the Methods Maintenance screen.  Here you can add your second part, test2b, to this subassy,.  (Repeat steps 3 and 4).
5) Click OK and parts appear on the bill for your subassy.
When your subassy is built we go to the top assy part, (Initials) test1 and add the subassy to the revision of that part. (steps 1  4).
When subassy is added, pick any part of your choice to add to the top assy.
View of your top assy part before adding another part.  Your part will be added as a level 1.

Now we will look at the options to add a BOM from an existing one.
The options are:
          Get from Methods
          Get from Jobs
          Get from Quotes
          Import
We have not verified this yet, but import is from AutoCAD bill of material on drawings and that is an option we may use once we verify how well it works.

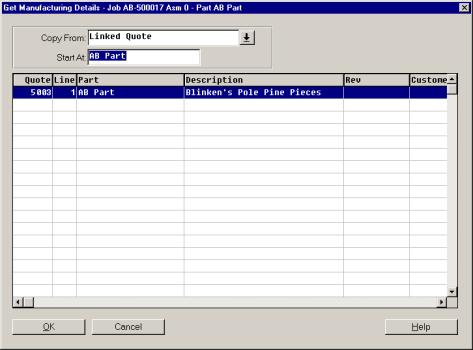

Here are the steps to copy a BOM using Get from Jobs
(See next page Adding a BOM)

REPORT OPTIONS
Advanced Bill Of Material
Reports
Availability
This report displays the indented components for each part revision, along with available stock quantity.  The report is intended to answer the question "Can I build this part today?".
Most often you will want a typical BOM, an indented Bill of Material (without costs)
This report is called BOM Listing
From Parts& button, you may pick the upper assembly level part number of the BOM.
Click on the binoculars to pull up a list of part numbers.  Choose Manufactured rather than Purchased to get the assembly list.
You can add more than one to your list.*
For Report Format pick Indented Level
If you are looking for all finished goods in a Product Group (the choice under parts) check New Page per Final Assy.*
Check Print Preview so you can see on your screen the report before it is sent off to the printer to verify the report shows what you want.
BOM Cost
This report prints cost information for the part revisions selected.  If you select specific parts for printing, you can enter specific production quantities.
Printed costs are broken down into 3 categories:  Material (which includes subcontracting), Labor, and Burden.
Summarized BOM
This report summarizes the raw material requirements for each part revision, for purchasing/inventory analysis.  The report also includes current inventory on hand and available quantities.
Subassemblies that are "viewed as assemblies" are not summarized, only their components are.  Each component is printed, with the total quantity required, regardless of where in the bill it is used.
Methods Master
This report is a master listing of the bill of materials and routing information entered for each part.
Where Used

Google
